10 - Cross-Ditch (Pullback) Description, Expectations

Description

photo: cross-ditches in pullback

Cross-ditches in pullback are used to restore hillslope drainage to historic (pre-construction), natural flow patterns. Cross-ditches are located at gully channels, natural depressions and swales which have evidence of stream flow and seepage above the road. The size, depth and shape of a crossditch depends on hillslope and gully contours, but it should always mimic natural ground profiles and contours. In this picture, note the recontoured slopes. If sediment transport is a concern, then more armour is needed at the bottom of the cross-ditch.


Expectations

  1. Decompact, remove and outslope the road surface in the vicinity of the cross-ditch.
  2. Remove all fill from gully. The order of pullback placement must be planned.
  3. Re-establish watercourse to native ground if possible.
  4. Reslope gully sidewalls to natural stable angles.
  5. Place rock in base of re-established gully if natural gully channel is erodible. Key in the lowest row of rocks for toe support.
  6. Never direct water onto unstable slopes/unprotected erodible soil. "Cross-ditches in Pullback" Practices aim to mimic natural hillslope contours and drainage paths wherever possible.

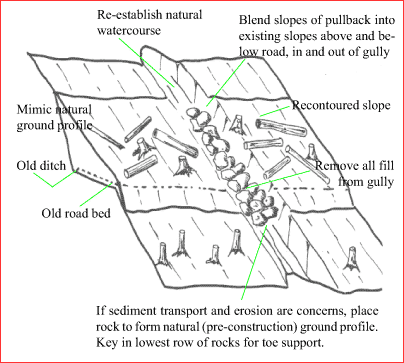

Figure 3: Cross-Ditch in Pullback
diagram: cross-ditch in pullback
